Substation Modernization

We’re modernizing our substation infrastructure to ensure stable, reliable electricity delivery in Medicine Hat.

We plan to renew (modernize) three key electrical substations: MHS-2, MHS-3, and MHS-5.

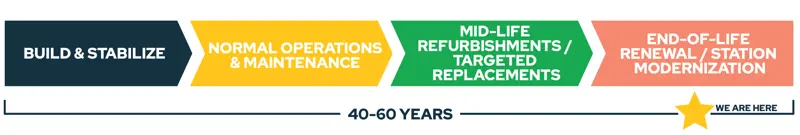

Substation overall business life

40-60 years

Service life can be extended through renewal, which is what this project will do.

Power transformers

40-60 years

depending on condition

High-voltage circuit breakers

25-40 years

Breakers can sometimes longer with refurbishment but replacement is often driven by condition, availability (or lack) of parts, or obsolescence.

Protection and control

10-25 years

These are relays, RTUs, SCADA, comms and are usually dependent on technology and supportability.

Station batteries

5-15 years

Condition is chemistry and temperature dependent.

Control building (structure)

40-60 years*

*HVAC systems to cool the electrical infrastructure typically need to be replaced within 5-15 years.

Frequently asked questions

Phase 1 of the substation modernization program focuses on the first three high-priority substations MHS-2, MHS-3, and MHS-5.

The estimated cost of Phase 1 is $45 million between 2026-2030.

  • 13 million was already approved in the 2025-2026 capital budget.
  • $21.55 million was added to the 2026 budget from Capital Reserves so we can pre-order equipment.
  • We will consider the remainder (currently estimated at $10.45 million) in the sustaining capital requests for the 2027-2028 budget cycle.

A 2025 independent assessment found high-priority issues at these sites. Much of the equipment is original (commissioned in 1984) and is now 40–45 years old.

We try to be as fiscally astute as possible and not spend money too early. We have stretched the most we can out of these assets and it is now time to rejuvenate.

Long lead times for key components and industry-wide cost increases mean earlier ordering is needed to reduce risk. Safety and reliability risks are only partially mitigated until the substations are modernized, so proceeding now helps accommodate earlier delivery of long-lead parts.

  • May 2026: RFP to secure bulk pricing and delivery of seven transformers
  • Fall 2026: Additional RFPs for breakers, medium-voltage switchgear, and disconnect switches

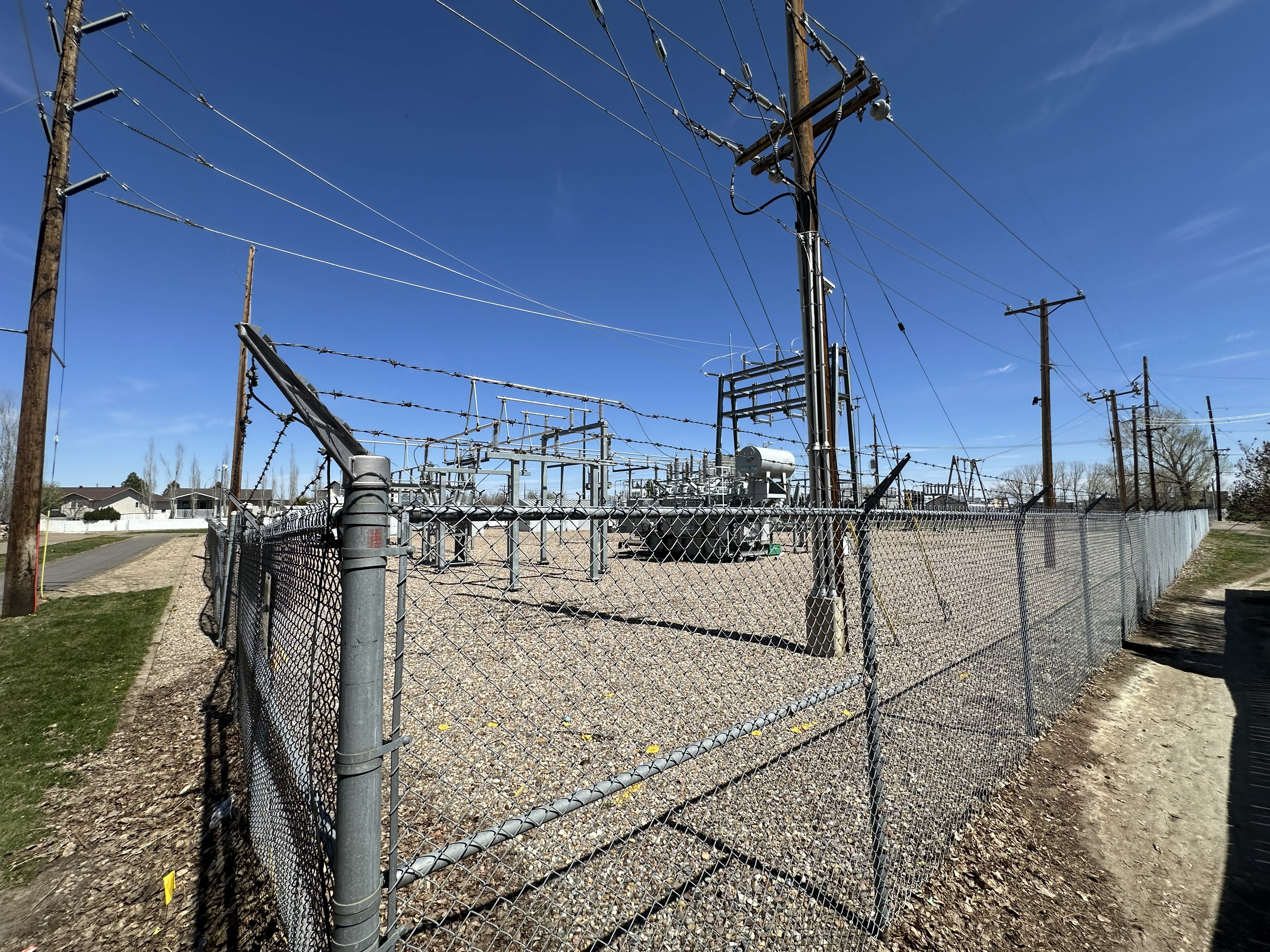

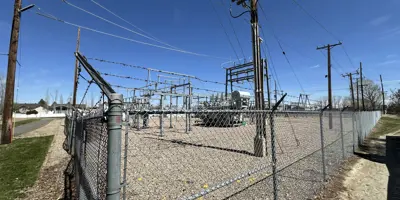

  • Spring/fall 2028: MHS-3 construction

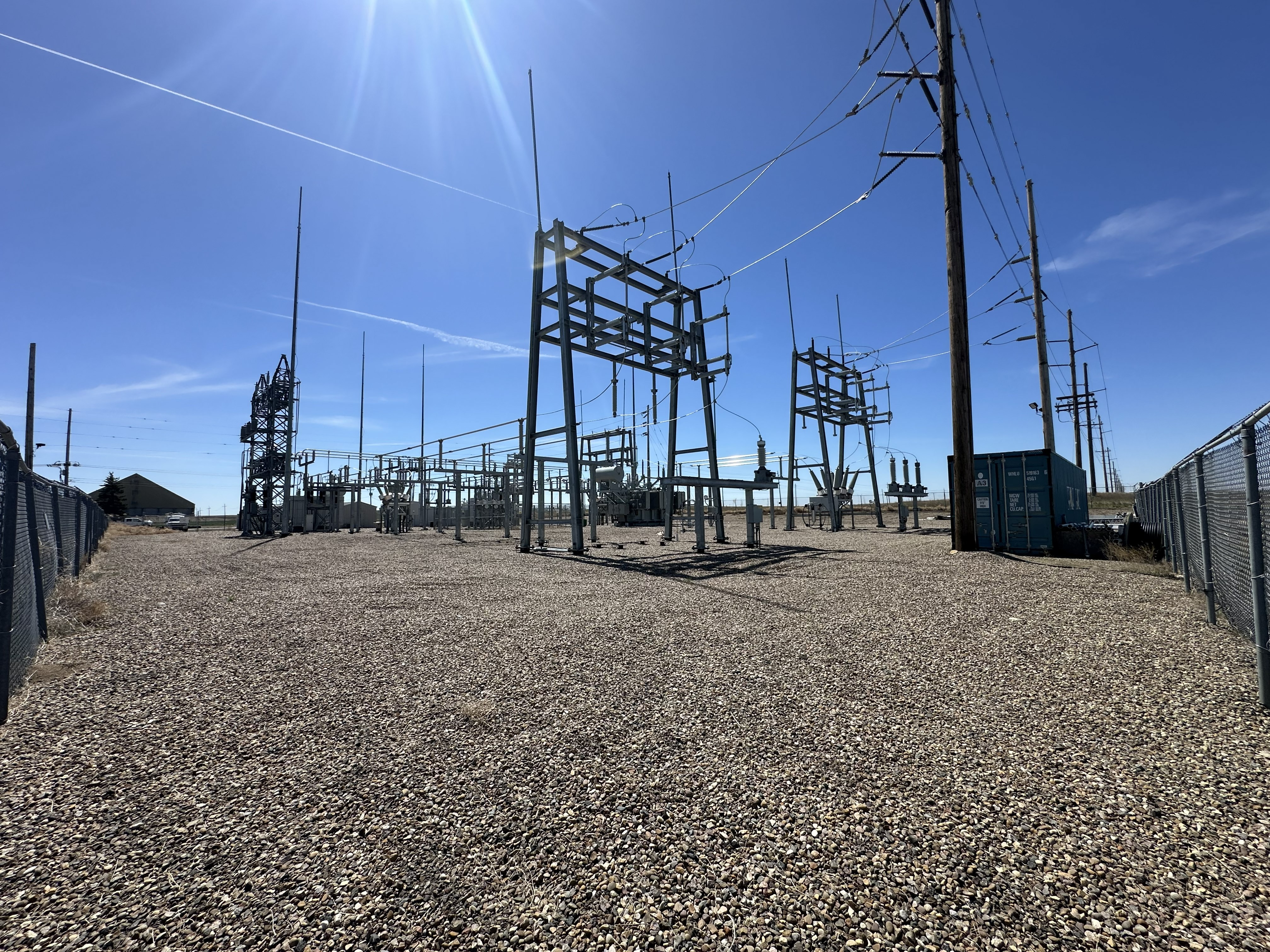

  • 2029-2030: MHS-2 construction

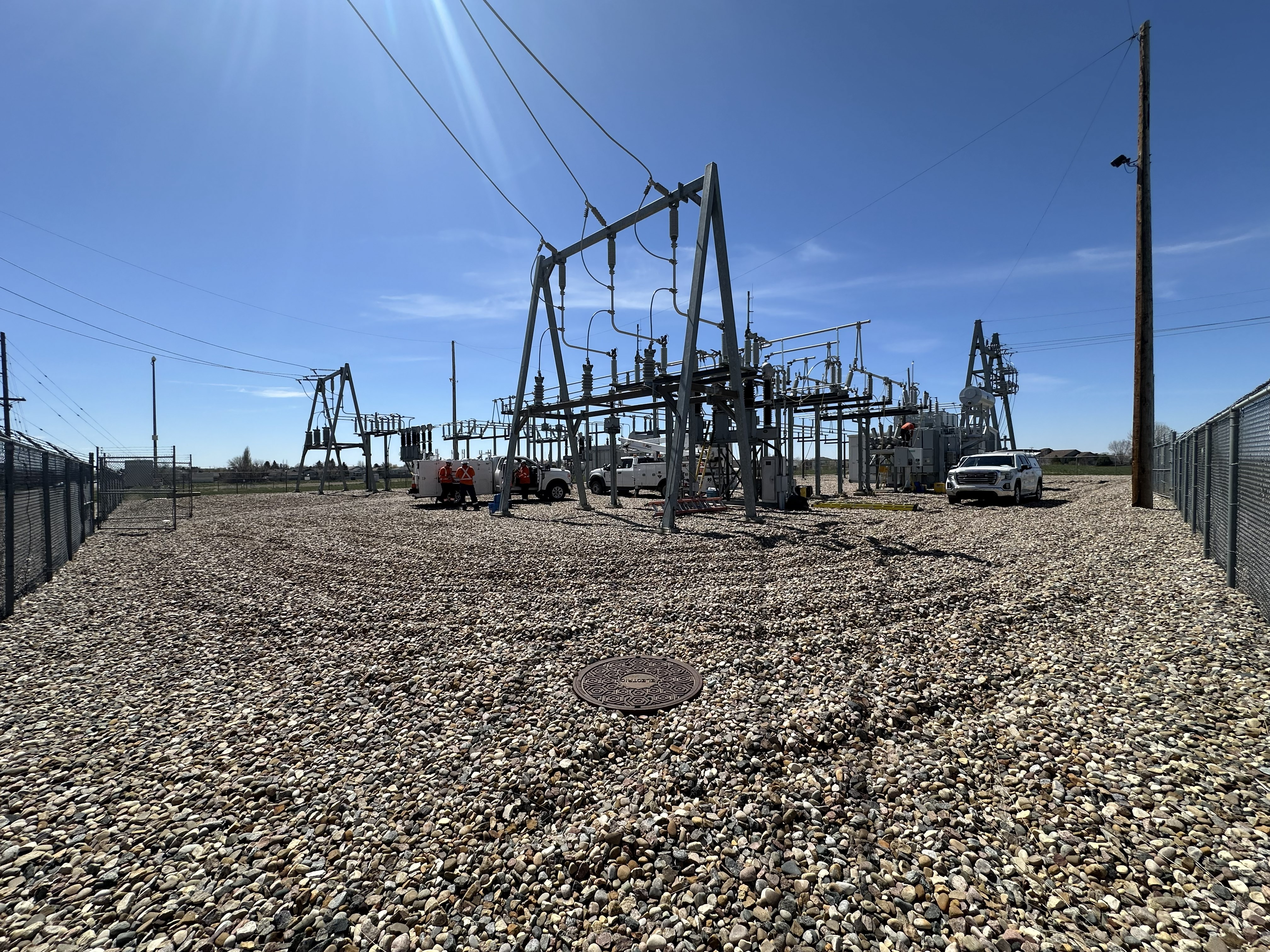

  • 2030-2031: MHS-5 construction

Older equipment increases safety and reliability risks, may create regulatory compliance concerns, and raises the risk of major equipment failure, especially because critical components have no readily available spares.

No. A preliminary evaluation found a full upgrade to 138kV is not required on these stations for current or near-term electricity demand.

The recommended approach is a “Replace-in-Kind” 69kV modernization strategy. However, we are incorporating equipment choices that support safety and compliance, such as dual-voltage transformers and 138kV-rated breakers, without converting the entire system to 138kV.

The addition of MHS-11, which will be in-service in 2027, satisfies identified electricity needs for growth in Medicine Hat’s south.

Yes. There will be planned electric service disruptions during the modernization process. Residents and businesses will be informed about planned disruptions as they near.

Yes, in the future. The City’s distribution rates are set using a cost-plus approach. Therefore, costs for a specific asset do not generally appear on utility bills until the asset begins to depreciate, which is planned for 2028 when MHS-3 is upgraded.

Other electricity work (like MHS-11) may impact rates earlier, but specific to this project, effects won’t appear until 2028.

The costs to maintain/renew electric infrastructure are recovered through two charges on your utility bill: Service charge and Facilities Usage charge. To learn more about the charges on a residential utility bill, go to medicinehat.ca/utilitybill.

The Medicine Hat advantage:

Medicine Hat’s rates are still lower. Our customers avoid transmission fees, thanks to the exemption in the Electric Utilities Act that allows us to own and maintain our own grid.

Subject to provincial legislation and regulation, the City of Medicine Hat owns and operates the distribution system within the electric franchise area, and City Council regulates the related distribution rates.
